Concrete Mixer: The Complete Guide for UK Extension and Renovation Work
Everything you need to know about hiring and using a concrete mixer on site: mix ratios, loading order, cleaning, hire vs buy, and when to call a ready-mix lorry instead.
Your bricklayer turns up on day two of the blockwork and asks where the mixer is. You've hired everything else but forgot the mixer. He quotes you half a day's standing time while you chase one down. On a project where trades cost £200–£350 per day, that's an expensive oversight for a machine that costs a fraction of ready-mix concrete per day to hire. The concrete mixer is an unglamorous piece of kit. No one puts it on the equipment list until someone needs it and it isn't there.
What it is and when you need one
A concrete mixer is a rotating drum mounted on a steel frame with a petrol or electric motor. The drum spins continuously, tumbling cement, sand, aggregate, and water together until they form a homogeneous mix. That's it. There's no technical mystery here.
What makes the mixer indispensable on an extension project is volume and consistency. Mixing concrete or mortar by hand on a board is feasible for a single small patch. It is not feasible for 200 blocks' worth of mortar or for a drainage haunching pour. The mixer handles repetitive batches at a consistent quality that hand-mixing cannot reliably produce at scale.
The machine has limits. It is for mortar and small batches of concrete only. For foundation strip pours, pad bases, and anything over about 2 cubic metres, ready-mix delivered by lorry is faster, less labour-intensive, and almost certainly cheaper once you factor in materials and time. The mixer fills the gap between "too small for ready-mix" and "too large for a bucket and trowel."
On an extension project you'll need it at four main stages:
- Blockwork and brickwork: mortar for every course
- Drainage: haunching concrete around and beneath drain pipes
- DPC bed: mortar bed under the damp-proof course
- External works: mortar for paving, pointing, kerbing

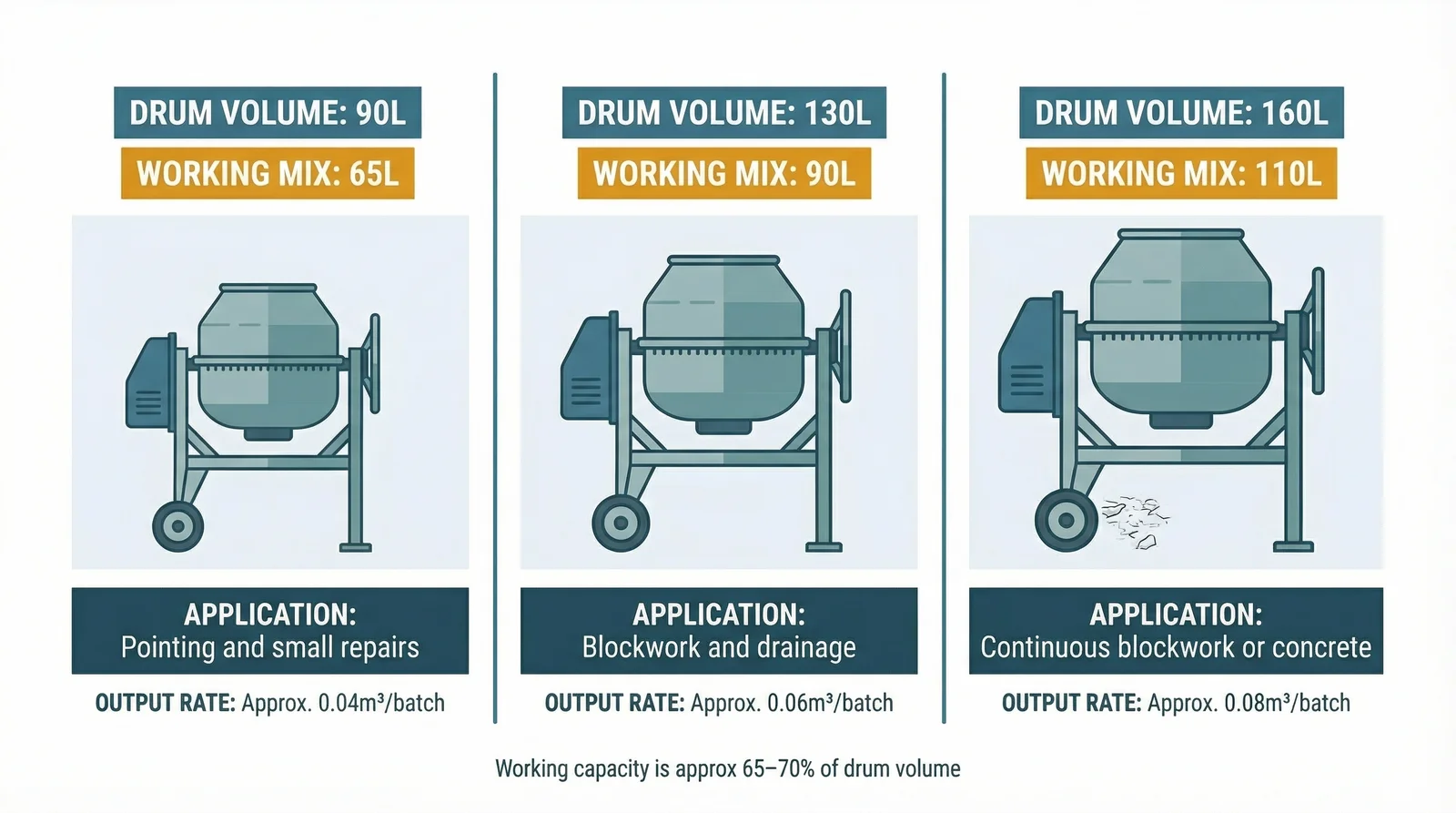

Drum sizes: what fits which job
UK hire depots typically stock mixers by drum capacity: 90L, 130L, and 150–160L. The working mix capacity is always less than the drum volume (typically 65–70%). A 130L drum (the standard hire machine, usually a Belle Minimix 150 or equivalent) gives you about 90L of usable mix per batch. That's approximately one full builder's wheelbarrow.
For blockwork mortar, a 130L machine and an experienced bricklayer are well matched. A good blocklayer uses approximately 1.5L of mortar per standard 440×215×100mm block. A 90L batch covers about 60 blocks, which is roughly one working hour for a productive bricklayer. The machine keeps pace. If your bricklayer is running two courses simultaneously on a large build, a 160L machine keeps the mortar flowing without waiting on the mixer.
For drainage haunching and DPC work, any machine in the 90–130L range is more than adequate. You're making smaller, occasional batches rather than a continuous production line.
Mix ratios
The wrong mix ratio causes real problems: mortar that's too strong cracks the blocks; mortar that's too weak has no compressive strength; concrete that's too wet shrinks and cracks; concrete that's too dry is unworkable and won't compact properly. These are not theoretical concerns. They are the most common causes of failed building control inspections and callbacks.
Standard mixes by application:
| Application | Mix ratio | Specification | Notes |
|---|---|---|---|
| Standard blockwork mortar | 4:1 (sand:cement) | Mortar designation M4 | Four parts building sand to one part cement. Use a plasticiser or lime (not both) for workability. The most common extension mix. |
| Hard-wearing brickwork (exposed) | 3:1 (sand:cement) | Mortar designation M6 | Stronger than necessary for internal blockwork; correct for exposed gables, copings, and below-DPC work. |
| Screed bed | 3:1–4:1 (sharp sand:cement) | Screed mix | Sharp sand, not building sand. Drier than mortar. Should just hold its shape when squeezed in your hand. |
| General concrete (shed bases, haunching) | 1:2:4 (cement:sand:aggregate) | Approx C20 | Standard domestic mix for non-structural concrete. Correct for pipe haunching, post bases, small slabs. |
| Blinding concrete beneath foundations | 1:3:6 (cement:sand:aggregate) | Approx C10–C15 | Lean mix, not structural. Used as a level bed for formwork. Do not use 1:3:6 for the foundation itself. |
| Domestic strip foundations | 1:2:4 (cement:sand:aggregate) | Approx C20 | What building control expects. 1:3:6 is not adequate for foundation strip concrete (a common error). |
The conflict between 1:3:6 and 1:2:4 for foundations is worth addressing directly. Some older references and trade habits treat 1:3:6 as the standard foundation mix. It isn't. BS 8500 designates 1:3:6 as approximately C10–C15 strength, which is a lean blinding mix. Domestic strip foundations in England and Wales are expected to achieve C20 minimum (1:2:4). If your building inspector or structural engineer specifies otherwise in writing, follow that. If they don't specify, use 1:2:4.
On mortar for blockwork: the 4:1 ratio is the right starting point. There is a persistent habit among experienced bricklayers of going slightly richer (3.5:1 or 3:1) on the assumption it's stronger, but mortar that is stronger than the blocks it binds can cause cracking in the blocks themselves when thermal movement occurs. Match the mortar strength to the block type.
How to use a concrete mixer properly
This is the section most equipment guides skip. The machine is simple to start, straightforward to operate, and completely capable of producing bad mix if you use it incorrectly.
The loading sequence

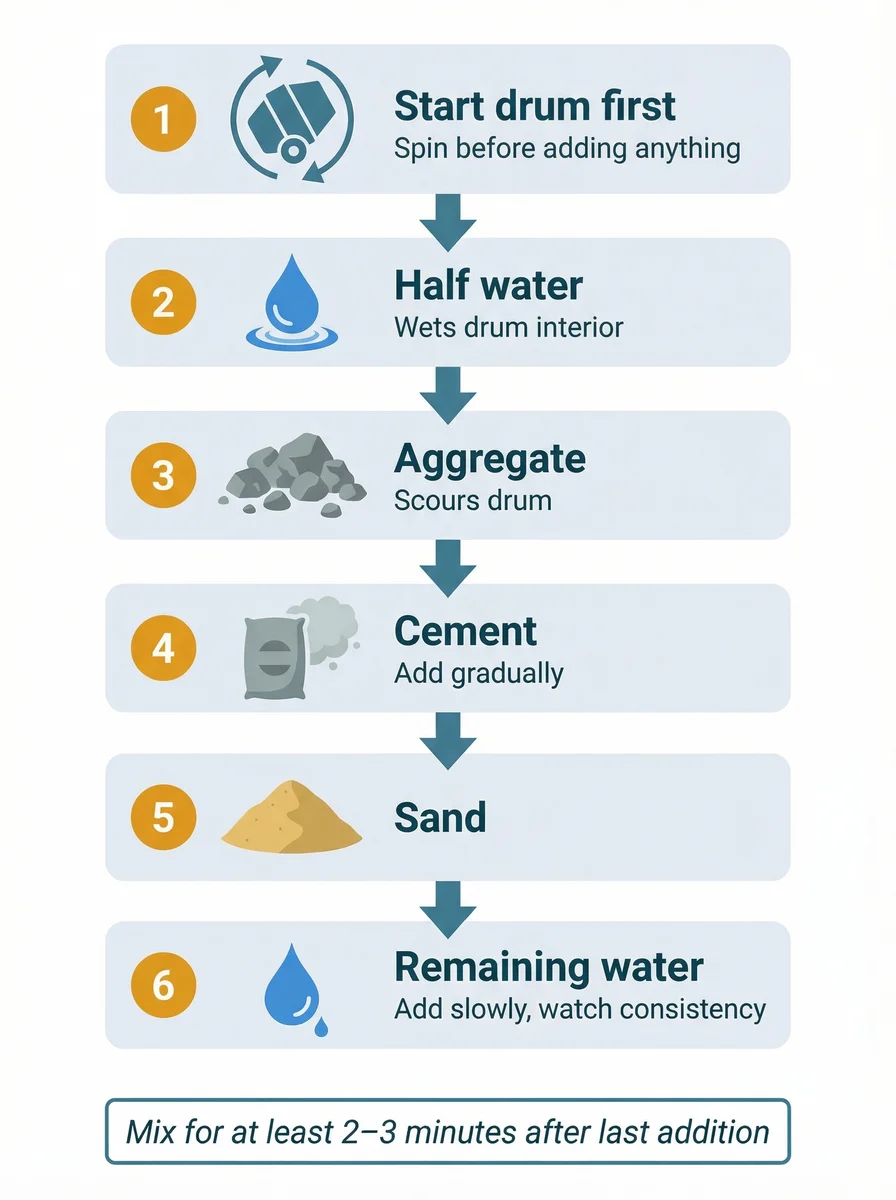

Order matters. Load the materials in this sequence and you'll get a consistent mix with minimal effort:
- Start the drum spinning before adding anything.
- Add approximately half your water allowance. The water primes the drum surface and prevents dry material from clumping in the back of the drum.
- Add your coarse aggregate (gravel or stone). This scours any residual material from the drum interior and begins coating the aggregate with moisture.
- Add your cement. Add it bag by bag or bucketful by bucketful, not all at once.
- Add your sand.
- Add the remaining water gradually, watching the mix consistency. Stop adding water before the mix looks right. It continues to loosen as it mixes.
The sequence matters for one reason: if you add sand and cement to a dry drum before any water, they tend to ball together in the back of the drum and don't mix through. The water-first approach breaks this tendency.
Mix for at least two to three minutes after the last addition. A mix that looks done after sixty seconds often has unmixed dry pockets. Two to three minutes of continuous rotation at full drum speed is the minimum for a consistent result.
Batch consistency: use buckets, not shovels
This rule is stated by every experienced bricklayer who has taught mixing on site, and ignored by a large proportion of the people who mix on site. Shovelfuls are not consistent. The amount of sand on a shovel depends on the moisture content of the sand, how you loaded the shovel, and whether it was a flat scoop or a heaped one. If each shovel is even 20% different from the last, your 4:1 mix could be running at 3.5:1 for one batch and 4.5:1 for the next. The colour difference between batches of blockwork laid with inconsistent mortar is visible from the street.
Use buckets. Fill each bucket level to the top and give it a brief shake to settle. Use the same bucket for all materials in the batch. Fill enough buckets before you start a batch that you don't lose count partway through. For a 90L batch with 4:1 mortar, you're looking at eight buckets of sand and two buckets of cement. Measure all of it before the drum turns.
Water is the most common way to ruin mortar. Adding too much water weakens the mix (increases the water-to-cement ratio, reducing final compressive strength) and makes it unworkable once it starts to stiffen in warm weather. Add water gradually in the last step of loading, not all at once. A mix that's slightly stiffer than ideal can always have a small amount of water added; a mix that's too wet cannot be corrected.
Overloading
Overloading the drum is the other common error. The rated working capacity of a 130L drum is approximately 90L. If you push it to 110L, the material does not tumble through the full mixing action. It sits in the bottom of the drum and rotates with it rather than being thrown through. The result is a poorly mixed batch that looks done but has unmixed pockets. Worse, overloading strains the motor and gearbox, which on a hired machine is your problem in the form of a damage charge.
Fill the drum to its rated working capacity and stop. It takes less time per batch than troubleshooting a failed mix or arguing with the hire depot about a burnt-out motor.
Site-mix versus ready-mix: when to switch
This is a genuine decision, not a preference. Getting it wrong costs time and money in both directions.
The practical threshold is approximately 2 cubic metres. Below 2m³, site-mixing with a hired drum mixer is efficient. Above 2m³, a ready-mix lorry becomes faster, less labour-intensive, and often cheaper once you account for the cost of bagged materials and the time to mix 100+ loads.
The numbers illustrate why. A 90L mixing drum produces roughly four batches per hour in practice (accounting for loading, mixing time, and emptying). At 90L per batch, that's 360L per hour, or 0.36m³. A 5m³ foundation pour requires approximately 14 hours of continuous mixing. That's one-and-a-half working days of mixer operation, not counting the labour cost of two people maintaining the pace.
Ready-mix C25/30 concrete delivered (national)
£90 – £130
Add the short-load surcharge for small orders:
Short-load surcharge (under 4–5m³)
£40 – £150
For anything structural and over 2m³, get a ready-mix price. For drainage haunching, DPC beds, and blockwork mortar, the mixer earns its hire cost every day.
On bagged cement versus bulk deliveries: for an extension build lasting 3–5 months, bulk sand and aggregate deliveries (tonne bags) are more economical than buying individual 25kg bags from a builders' merchant. The mixer doesn't care about the source. But loose sand from a tonne bag takes on moisture quickly if left uncovered, which affects water-to-cement ratios. Keep tonne bags sheeted until needed.
Hire or buy?
Hire for the vast majority of self-managed extension projects. The economics are straightforward at first, then they flip.
Concrete mixer hire - day rate
£20 – £40
Concrete mixer hire - week rate
£35 – £100
The week rate (see above) varies by supplier and machine size. A typical extension blockwork phase runs 4–8 weeks, so hire costs add up over the project. Purchase of a Belle Minimix 150 new costs:
Belle Minimix 150 - new (240V electric)
£450 – £560
The break-even depends on where you hire. National chains charge less per week, so it takes longer to justify the purchase: a new Minimix 150 breaks even against national hire rates (£35–50/week) at roughly 9–16 weeks of use. Against independent hire companies, which charge more (£75–100/week), the same new Belle breaks even in about 5–7 weeks. The second-hand market changes the calculation further:
Belle mixer - second-hand (Facebook Marketplace / eBay)
£150 – £300
Electric versus petrol: for any domestic site with a 240V supply (or a site transformer for 110V), electric is the right choice. Petrol introduces fuel storage, oil checks, a choke procedure on cold starts, more noise, and emissions in any enclosed area. Electric is simpler, quieter, and reliable. Petrol becomes the right choice on remote sites with no power supply, or where the run to a power source is too far.
The Belle brand: why it dominates
Every hire fleet in the UK is stocked predominantly with Belle machines. The brand is owned by Altrad and manufactured in the UK, with current production at a Derbyshire facility. The reasons hire companies use Belle come down to two factors: parts availability and durability.
Genuine Belle parts are available through Machine Mart, HSS depots, and numerous trade suppliers. A drum paddle that wears out can be replaced rather than requiring the whole machine to be scrapped. Community reports of Belle mixers from the 1980s and early 1990s still in productive use are not exceptional. For a hire company, a machine that runs for 25 years with only consumable parts is a very different capital investment than a budget machine that lasts 5.
For the self-builder buying rather than hiring, the same logic applies. A used Belle at £200 is a more reliable investment than a new budget mixer at £180. The used Belle will outlast the project. The budget machine may not.
Keep a 1-tonne bulk bag (the empty kind your aggregate arrives in) near the mixer. It fits neatly over most small drum mixers as a weather cover. Keeping the drum dry between uses prevents mortar residue from hardening inside the drum.
Cleaning: non-negotiable
Cleaning is the part that gets skipped at end of day when everyone is tired. It is the single biggest cause of damage to both hired and owned mixers.
Concrete begins its initial set within 30–45 minutes. Mortar, which has a slower set time, typically begins firming within 2 hours. Concrete or mortar that sets inside the drum permanently reduces its capacity, throws off balance, damages the paddles, and eventually renders the machine unusable. This is a damage charge from the hire company, or a ruined machine if you own it.
The correct cleaning method takes 5 minutes. Before the mix has been in the drum for more than 30 minutes:
- Tip out any remaining mix completely.
- Add a half-bucket of clean water and a half-bucket of coarse gravel or shingle.
- Run the drum for 60–90 seconds. The grit scours the drum interior.
- Tip out and rinse with clean water.
That's it. Monthly on a heavily used machine, a diluted brick acid wash will remove any calcium carbonate buildup that the water-and-grit method misses.
Do not leave concrete or mortar sitting in a stopped drum. The drum must be either rotating continuously or fully cleaned. A drum left with mix inside for even an hour in warm weather may have partial set that the paddles cannot break up when restarted, causing the motor to stall and potentially burn out.
Collecting and returning a hired machine
Hired mixers are available from national chains (HSS, Speedy Hire, Sunbelt Rentals) and local plant hire companies. The collection process is standard: two forms of ID, a credit card security deposit, and a demonstration of the machine before you leave the depot.
Check these things before you accept the machine:
- Drum condition: no major concrete buildup inside that would affect capacity
- Paddles: present and not heavily corroded or broken
- Power cable: no nicks or cuts in the insulation on the 240V cable; for 110V, the yellow casing should be intact with no exposed conductors
- Tipping mechanism: the drum should lock securely at the tilted-up (non-mixing) position and release cleanly; a lock that slips can tip the drum contents unexpectedly
- Motor: run it for 30 seconds at the depot and listen for grinding or abnormal noise
On return, clean the machine thoroughly before you take it back. Any concrete residue inside the drum that the depot considers deliberate neglect will attract a cleaning or damage charge. Given that cleaning takes 5 minutes, this is not a difficult bar to clear.
Weather: cold and hot
Cold weather: concrete and mortar require sustained temperatures above 2°C to hydrate properly. Below 2°C, hydration slows significantly. Below 0°C, water in the mix can freeze before hydration completes, causing permanent structural damage. The concrete appears set but has almost no strength.
If frost is forecast within 24 hours of your pour or lay, defer the work. If you must mix in cold conditions, use slightly warm water in the mix (not hot, which can cause flash setting), store cement and aggregate off cold ground and under cover overnight, and protect fresh work immediately with insulating blankets or dry burlap. For a fresh slab, even timber formwork boards provide significant insulation.
Hot weather: the issue inverts. In warm weather (above 20°C) mortar and concrete stiffen quickly as water evaporates. Mix only what you can use within 20–30 minutes. Don't mix a full 90L batch in the morning sun and then spend 40 minutes laying it; the last third of the batch will be stiff and unworkable. Mix smaller batches, more frequently. Keep sand and aggregate out of direct sun if possible.
Where you'll need this
Concrete mixers appear across all stages of any extension or renovation project that involves masonry, groundwork, or concrete work:
- Walls and blockwork - mixing mortar for every course of blockwork throughout the structure phase
- Foundations and footings - mixing small concrete batches for blinding and making good; ready-mix handles the main strip pour
- Damp-proof course - mortar bed beneath the DPC and small concrete infills around DPC details
- Drainage - haunching concrete around drain pipes and bedding mortar for inspection chamber frames
- Garden and external works - mortar for paving, kerb edging, and pointing
